HS2 Main Trace Earthworks
Delivery of 1.2 km of HS2 main rail trace earthworks from formation through to finished level, within the required tight design tolerances as well as rectification of the Colne Valley Viaduct transition zone.

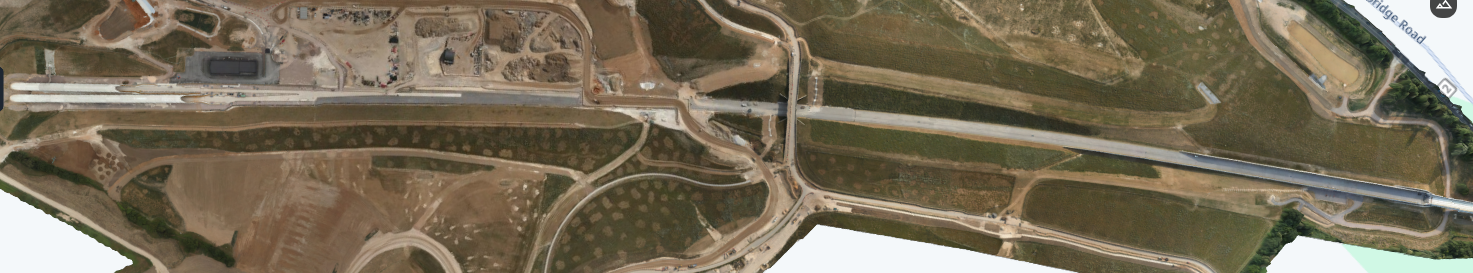

Drone photo of main trace - From the colne valley viaduct to the chiltern tunnel.
Formation to Finished Level.
Swift Earthworks supported the completion of approximately 1.2 km of HS2 main rail trace, extending from the Colne Valley Viaduct towards the Chiltern tunnels.

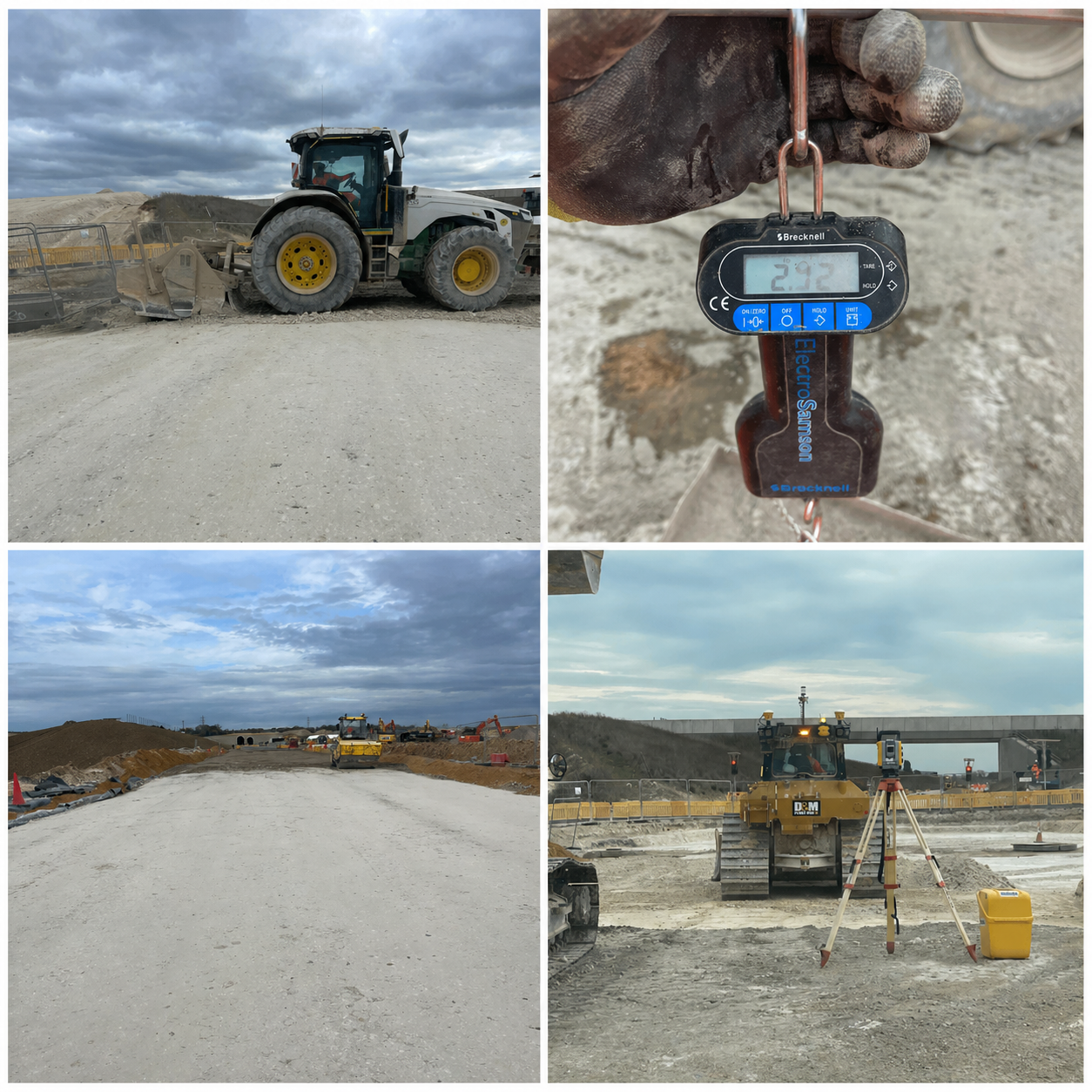

Works included setting out, machine-control support, layer checks, daily as-built surveys and level verification from formation to finished level. Materials including 6F6, 6F8 and stabilised 6E chalk were placed and compacted, with NDM and EV2 testing coordinated to ensure compliance with design specifications.
The trace was delivered to a tolerance of ±10 mm at finish level through close coordination with the site team and testing subcontractors.
- Topsoil placement on both embankments
- UTS/GPS machine-control
- Setting out, Layer-level surveys and as-built/isopachyte verification
- Earthworks QA
- Material compliance and coordination of geotechnical/in-situ testing
- Stabilisation of cohesive/granular material

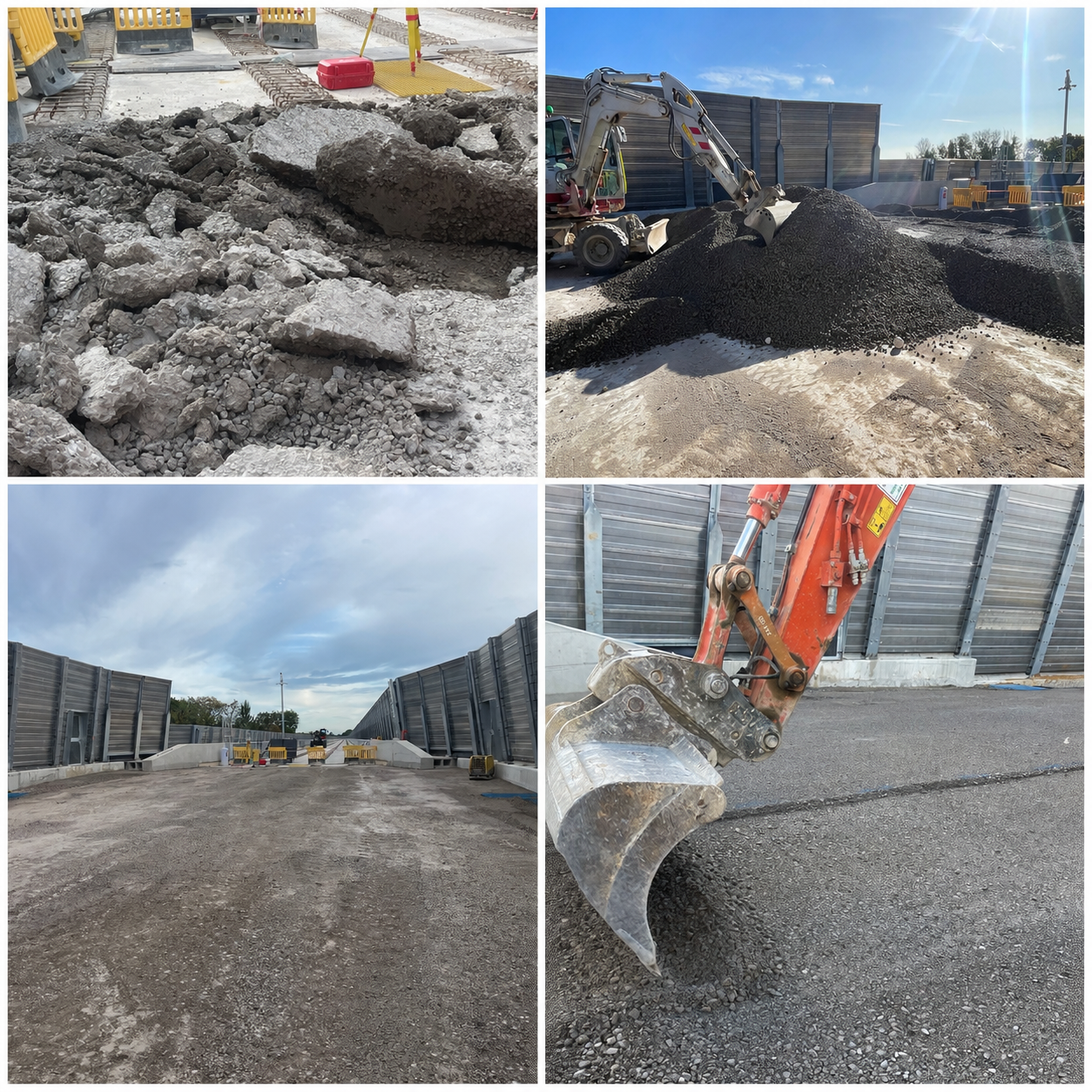

In-situ cement stabilisation
- Cement stabilisation of 6E chalk from Existing ground level up to finish formation level
- Rectification of Colne Valley Viaduct Transition Zone Finish with use of stabilised 6F6 material.

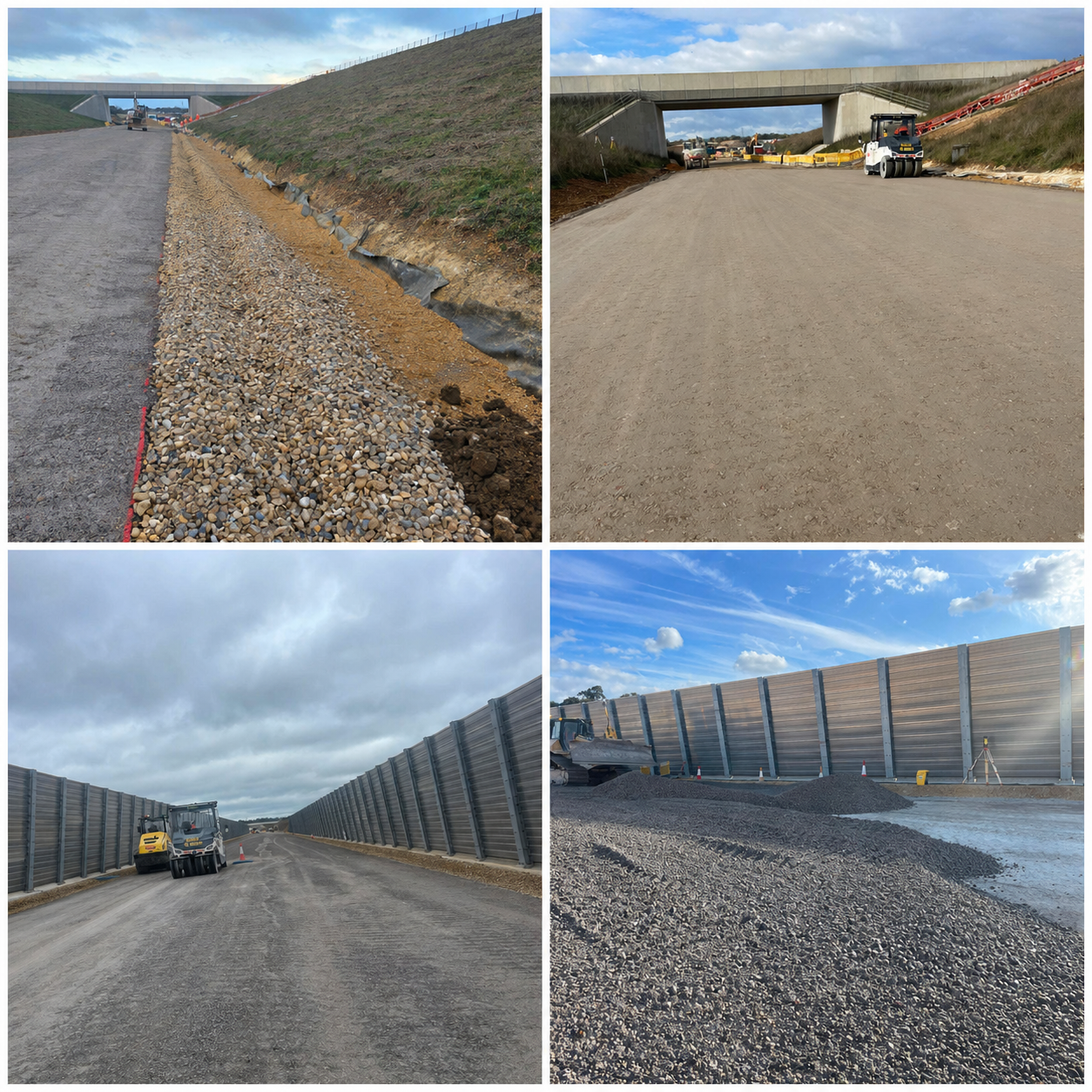

UTS/Machine Control | Fill, Trimming & Compaction
UTS (Universal Total Station) used in situations where formation/finish level tolerances are small (+/- 5 to 10mm) or in areas where GPS connectivity is poor.
Layer thicknesses and roll sequences are trialled prior to fill works to ensure compaction and compliance with specifications - in situ tests (NDM/CBR/EV2 etc) verify compliance.
Have a Project in Mind?
From earthworks strategy and specification guidance to QA, plant support and prework/post-work topographical surveys, we help you build with confidence and stay on programme.
HS2 Main Trace Earthworks
Cement stabilisation of 6E chalk from Existing ground level up to finish formation level
Rectification of Colne Valley Viaduct Transition Zone Finish with use of stabilised 6F6 material.
Drone photo of main trace - From the colne valley viaduct to the chiltern tunnel.
UTS/Machine Control | Fill, Trimming & Compaction
UTS (Universal Total Station) used in situations where formation/finish level tolerances are small (+/- 5 to 10mm) or in areas where GPS connectivity is poor.
Layer thicknesses and roll sequences are trialled prior to fill works to ensure compaction and compliance with specifications - in situ tests (NDM/CBR/EV2 etc) verify compliance.
Project Overview
Swift Earthworks supported the completion of approximately 1.2 km of HS2 main rail trace, extending from the Colne Valley Viaduct towards the Chiltern tunnels.
Works included setting out, machine-control support, layer checks, daily as-built surveys and level verification from formation to finished level. Materials including 6F6, 6F8 and stabilised 6E chalk were placed and compacted, with NDM and EV2 testing coordinated to ensure compliance with design specifications.
The trace was delivered to a tolerance of ±10 mm at finish level through close coordination with the site team and testing subcontractors.
In-situ cement stabilisation
